Maple Street Maleny, streetscape upgrade
Maleny’s main street is being upgraded to be safer, more comfortable and easier to use for everyone who lives, works in and visits Maleny.
The streetscape project aims to improve the function and enjoyment of Maleny’s main street.
Maple Street and local businesses will remain accessible during construction, with works carefully staged to minimise disruption and keep the town moving. Construction is expected to be complete late February 2027 (weather and site conditions permitting)
Works planned for the next four weeks
Works planned for the next four weeks
The key focus over the next four weeks will be progressing construction of raised pedestrian crossings 2 and 3, starting major stormwater infrastructure works, continuing the staged below of footpaths, and managing the traffic impacts associated with crossing 3 completion.
Work activities and dates are subject to change due to circumstances outside of Sunshine Coast Council’s control including weather and site conditions.
Week commencing 28 September
Footpath construction in front of numbers 70 to 76 Maple Street Footpath construction in front of 53 Maple Street New raised pedestrian crossing 1 (Myrtle Street) reopened to pedestrians
Week commencing 5 October
Demolition of planter boxes in front of 43 Maple Street Removal of Underground Services Tank (UST) at 53 Maple Street Start of stormwater works and construction of raised pedestrian crossing 2 (Fig Street) Footpath construction in front of 38 Maple Street
Week commencing 12 October
Start of construction of northern section of raised pedestrian crossing 3 - this will require closure of westbound lane and detour via Coral Street Continuation of stormwater works and construction of raised pedestrian crossing 2 (Fig Street) Start of footpath construction in front of numbers 26 to 30 Maple Street
Week commencing 19 October
Continuation of construction of northern section of raised pedestrian crossing 3 - this will require closure of westbound lane and detour via Coral Street Continuation of construction of raised pedestrian crossing 2 (Fig Street) Continuation of footpath construction in front of numbers 26 to 30 Maple Street
School holidays - temporary traffic detour pause
To help minimise impacts during the school holidays, the temporary detour via Coral Street will be removed from 19 September to 6 October.
During this time, traffic will again be able to travel in both directions on Maple Street near the new pedestrian crossing outside the chemist.
The crossing will be partially completed, with temporary ramps, barriers and signage in place so it can be safely used by both pedestrians and vehicles.
Construction crews will continue working during this period. As a result, there may still be some temporary changes to parking and pedestrian access.

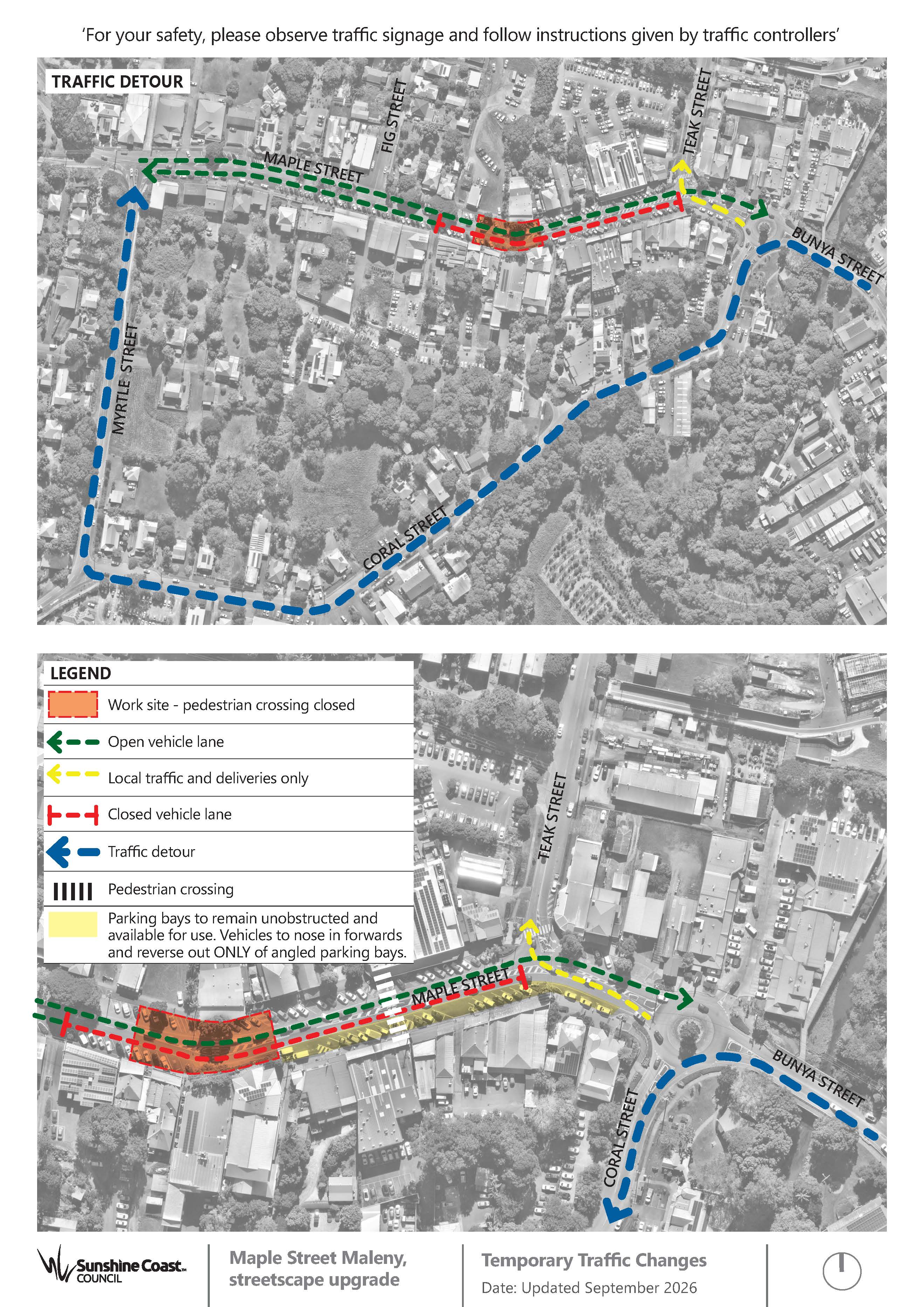

Temporary traffic detour
Crossing 3 works resume from Monday 12 October
Works to complete the northern half of the new pedestrian crossing outside the chemist will resume from Monday 12 October.
To safely complete these works, there will be temporary traffic changes in place for approximately two weeks. (Dates and durations are subject to weather, site conditions and Department of Transport and Main Roads testing and approvals.)
What this means for you
- The westbound lane of Maple Street will be closed between the Coral Street roundabout and Fig Street.
- A signed detour will be in place via Coral Street for westbound traffic.
- Teak Street, the IGA car park and Mitre 10 will remain accessible from both directions.
- Parking on the southern side of Maple Street will temporarily operate as nose-in, reverse-out angled parking.
Traffic controllers, signage and temporary traffic management will be in place.
Please allow extra travel time, as short delays may occur.
Please follow traffic signage and allow extra travel time while these works are underway.
*Local traffic can access Teak Street from the eastern end of Maple Street.
Thank you for your patience as we continue delivering these improvements for the community.

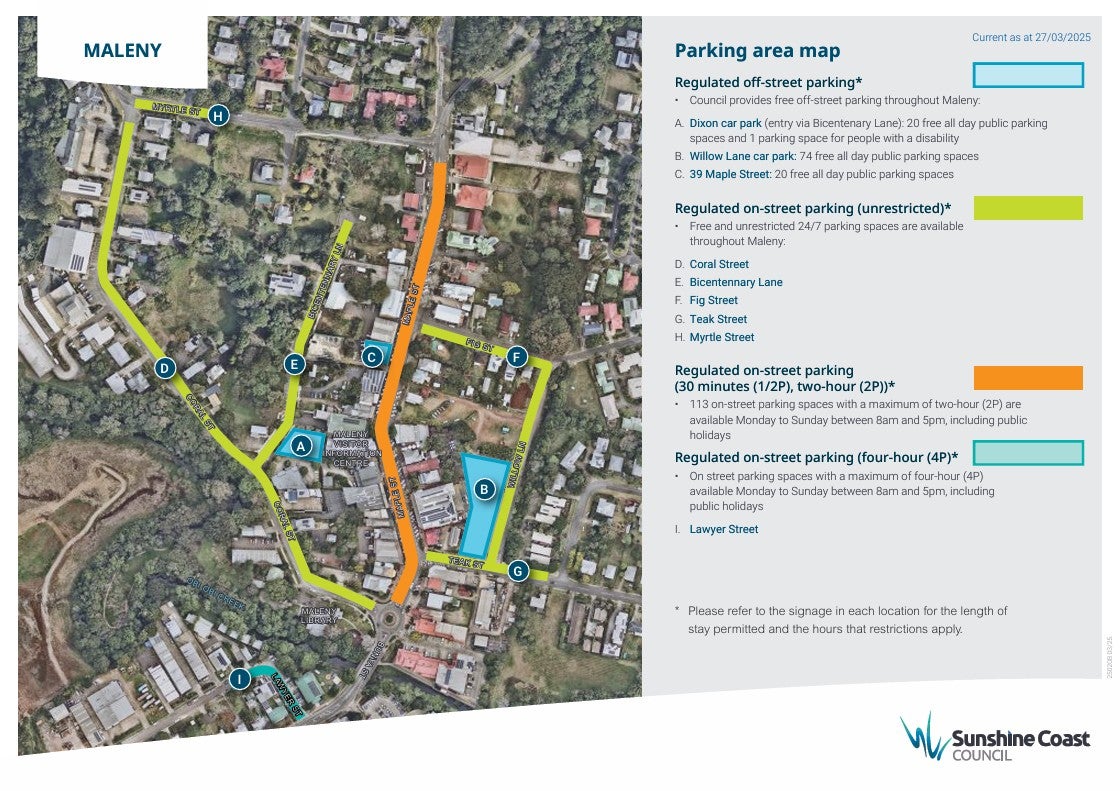

Parking map
Parking remains available throughout the Maleny town centre, including on surrounding streets and in nearby public car parks.
You can visit Council's website to view nearby parking options around Maple Street.
Please allow a little extra time during construction, particularly during busy periods.

Construction activities
Construction schedule
Construction schedule
Construction will continue to take place between 6am and 6pm. Night works are not expected at this stage
The new raised pedestrian crossing near the IGA (Zone 1, Area 1) is now complete and open to traffic.
Temporary ramps and handrails remain in place to allow pedestrians to safely use the crossing while surrounding works continue.
The construction contractor is working hard to mitigate impacts to our community however during these works, you may notice increased noise, vibration and dust at times.
Myrtle Street pedestrian crossing (Zone 2, Area 2)
Construction of the new pedestrian crossing near Myrtle Street (crossing 1) is progressing.
Footpath works (Zone 1, Area 2)
Crews have begun removing and rebuilding sections of footpath on the northern side of Maple Street, between numbers 40 and 44 Maple Street. This work is being done in preparation for the construction of crossing 3.
Footpath works (Zone 2, Area 2)
Footpath works will happen in stages along the western end of Maple Street, starting in late August for approximately eight weeks*.
New crossing near the chemist (Zone 1, Area 2)
Preparatory works for the new pedestrian crossing 3 near the chemist will begin from 31 August 2026*.
Due to site constraints and Department of Transport and Main Roads requirements, temporary traffic changes will be needed while this work takes place.
These include:
- Closure of the westbound lane between the Coral Street roundabout and Fig Street.
- A signed detour via Coral Street for west-bound traffic.
- This detour is expected to be in place for approximately 4 weeks*.
- Continued access to parking from the east-bound lane.
- Access to Teak Street, including the IGA car park and Mitre 10, will be available from the east-bound lane of Maple Street only.
- Temporary changes to parking on the southern side of Maple Street, with vehicles required to nose-in and reverse-out of angled parking bays.
- Please allow extra travel time while these arrangements are in place, as short delays may occur.
*Dates and durations are subject to weather, site conditions and Department of Transport and Main Roads testing and approvals.

Temporary changes to traffic, parking and loading
Temporary changes to traffic, parking and loading
You can still walk along Maple Street. Temporary footpath diversions will be in place when needed to keep everyone safe.
While work is underway, some parking spaces will be temporarily unavailable to help maintain traffic flow and provide a safe work area for construction crews.
There may also be changes to how some parking spaces are accessed and used. Signage will be in place to guide motorists.
The loading bay servicing the Community Centre and nearby businesses will remain operational. During construction of crossing 3 near the chemist, the loading bay will be accessible from the east-bound lane only.
The temporary traffic signs, barriers and bollards in place are approved by the Department of Transport and Main Roads and are there to help keep road users, pedestrians and construction workers safe. Please do not move or remove any traffic control devices. If you notice a sign or barrier that appears out of place, please let a member of the construction team or a traffic controller know.
Traffic management
The current Traffic Guidance Scheme (TGS) has been implemented to safely construct the new pedestrian crossing and has been reviewed and approved by TMR. The design of the traffic arrangements must comply with a range of legislative requirements, Australian Standards, workplace health and safety obligations, codes of practice and TMR operational guidelines.
While Council's preferred outcome would have been to keep both traffic lanes operating during construction, the narrow road corridor, the presence of underground services and compliance requirements meant this was not possible. The current arrangement was deemed the most suitable as it provides a shorter detour, accommodates heavy vehicles and avoids the need to relocate public transport infrastructure, including bus stops and the taxi rank.
The partial closure between Coral and Fig Streets prevent motorists, from reaching the construction zone and needing to undertake unsafe turning manoeuvres.
Since the partial Maple Street detour began on Monday 31 August 2026, Council has responded to community feedback and has made some amendments to the TGS with local traffic now able to access Teak Street from the eastern end of Maple Street during traffic control staffed hours.
From 3pm-6am Monday to Friday, and weekends when traffic controllers are not on site, access to Teak Street is via the original Coral Street/Myrtle Street detour.
You can visit Council's website to view nearby parking options around Maple Street.
Temporary traffic signage
Temporary traffic signage
The temporary traffic signs, barriers and bollards in place are approved by the Department of Transport and Main Roads and are there to help keep road users, pedestrians and construction workers safe.
Please do not move or remove any traffic control devices. If you notice a sign or barrier that appears out of place, please let a member of the construction team or a traffic controller know.
Business support
Maple Street will remain accessible during construction. The project team will continue to keep our community, including local businesses, informed of all construction activity.
A range of free resources are available via Council’s website to assist businesses during streetscape construction.
- Download the Business Continuity Guide
- Check out Events Sunshine Coast online: What's on in Maleny
- Contact Council to explore business programs including:
- Level Up Your Business
- Build A Better Business Program
- ASBAS Digital Solutions program and Council’s Community Grants Program.
We ask our community to continue to support local businesses during the construction period.
Business Activation Group
Council is working with Maleny Commerce, the newly formed Business Activation Group, and the broader business community throughout the project.
Made up of local business representatives, the Business Activation Group focuses on promoting Maleny, supporting town activation initiatives and providing a forum for business feedback and advocacy during the Maple Street Streetscape project.
We will continue to work collaboratively with the group to help keep businesses informed and support a vibrant and welcoming town centre throughout the project.
Frequently asked questions
Business support
Business support
Will access to businesses remain available during construction?
Yes. Council and the contractor are working to maintain pedestrian and vehicle access to businesses throughout construction wherever possible.
Access arrangements may change from time to time, however businesses will continue to operate and customers are encouraged to keep supporting local traders.
Will businesses be supported during construction?
Maple Street will remain accessible during construction. The project team will continue to keep our community, including local businesses, informed of all construction activity.
A range of free resources are available via Council’s website to assist businesses during streetscape construction: https://www.sunshinecoast.qld.gov.au/business
- Download the Business Continuity Guide
- Check out Events Sunshine Coast online: What's on in Maleny
- Contact Council to explore business programs including:
- Level Up Your Business
- Build A Better Business Program
- ASBAS Digital Solutions program and Council’s Community Grants Program.
We ask our community to continue to support local businesses during the construction period.
Council appreciates local businesses’ support of the project and recognises that any construction activity has an impact on our community.
The project team has been in regular contact with local businesses and the chamber of commerce and has actively explored opportunities to reduce impacts where it is safe and practical to do so, including adjustments to traffic management arrangements and maintaining access to businesses wherever possible.
Council encourages residents and visitors to continue supporting Maleny businesses during construction and notes that businesses remain open and accessible throughout the upgrade.
Council also offers free support for businesses, including practical guides and programs. You can find these on our website.
Construction workers as customers
Construction workers are potential customers.
If you have concerns about a project, constructions workers aren’t generally the right people to raise concerns with. If you have any questions about the project, please reach out to our team by emailing [email protected]
Or you can contact Council’s customer service via the details below, quoting ‘Maple Street Maleny Streetscape Project’:
- [email protected]
- 07 5475 7272
- Locked Bag 72 Sunshine Coast Mail Centre Qld 4560.
Are businesses being forced to close during construction?
No. Council is not directing businesses to close during construction. Business owners make decisions about their operating arrangements. Council and the contractor are providing advance notice of works, maintaining access where possible and working directly with businesses to minimise disruption.
Changed traffic conditions including on-street parking
Changed traffic conditions including on-street parking
How many car parks are being permanently removed?
The project will result in a net reduction of nine parking spaces. Some existing parking bays do not meet current safety standards, so the changes will improve safety, visibility and access for everyone.
While some existing spaces are being removed to improve pedestrian safety and accessibility, additional parking is available on nearby streets and in existing off-street parking areas.
To accommodate the new raised pedestrian crossings and related works, some permanent changes to parking conditions are needed. We’ve worked hard to keep as much parking as possible. This was a key consideration of the streetscape’s design.
All accessible PWD (People With a Disability) parking and motorcycle parking spaces will remain. Taxi parking outside the IGA, will also be improved to make it safer to get in and out.
Nearby parking available on surrounding streets includes Teak Street, Fig Street, Bicentenary Lane and the IGA carpark (when visiting the store).
Will there be people with disability parking and loading zones in the street?
All accessible PWD (People With a Disability) parking spaces will remain.
During construction these items will remain available however may be provided in different locations to ensure community safety.
Will there be temporary changes to traffic conditions?
Yes. To keep Maple Street accessible and continue to progress the works as quickly as possible some temporary changes to traffic conditions will take place during construction.
These may include single lane closures, traffic control, changed parking areas and loading bays, and road works.
All traffic changes must comply with a Traffic Management Plan (TMP) which is a formal document that outlines how to manage, control, and minimise risks to our community – including workers, pedestrians, and motorists during construction.
Any changes to traffic conditions must apply to the TMP.
The Queensland Department of Transport and Main Roads (DTMR) has also placed conditions on the project which we must adhere to.
The design of the traffic arrangements must comply with a range of legislative requirements, Australian Standards, workplace health and safety obligations, codes of practice and TMR operational guidelines.
While Council's preferred outcome would have been to keep both traffic lanes operating during construction, the narrow road corridor, the presence of underground services and compliance requirements meant this was not possible. The current arrangement was deemed the most suitable as it provides a shorter detour, accommodates heavy vehicles and avoids the need to relocate public transport infrastructure, including bus stops and the taxi rank.
The partial closure between Coral and Fig Streets prevent motorists, from reaching the construction zone and needing to undertake unsafe turning manoeuvres.
Since the partial Maple Street detour began on Monday 31 August, Council has responded to community feedback and has made some amendments to the TGS with local traffic now able to access Teak Street from the eastern end of Maple Street during traffic control staffed hours.
From 3pm-6am Monday to Friday, and weekends when traffic controllers are not on site, access to Teak Street is via the original Coral Street/Myrtle Street detour.
Why was the Coral Street detour changed?
Council continues to monitor construction impacts and make adjustments where possible.
To help reduce impacts during the school holidays, the Coral Street detour was temporarily removed from 19 September to 12 October, allowing two-way traffic to return to Maple Street near the new crossing outside the chemist.
Temporary ramps, barriers and signage were in place so the partially completed crossing could be used safely by pedestrians and vehicles.
Why are the works being undertaken during the day instead of at night?
The project program and budget have been based on undertaking the works as Monday-Friday dayworks. Daytime construction is the most practical and cost-effective way to deliver the project.
Night works can significantly increase project costs by anywhere between 20% and 50%. Nightworks would require the daily removal and reinstatement of traffic management equipment, adding complexity and potentially extending the overall construction period.
In some areas, it may be appropriate to deliver the works after hours, but this is on a case-by-case basis and subject to program and budget capacity.
Where possible, noisier activities are undertaken earlier in the day to minimise impacts on local businesses.
How are traffic changes decided?
All temporary traffic arrangements are developed by qualified traffic professionals and approved by the Department of Transport and Main Roads.
Traffic conditions are monitored throughout construction and adjustments are made where practical to reduce impacts on the community while maintaining safety.
Where can I park during the works?
Where can I park during the works?
While work is underway, some parking spaces will be temporarily unavailable to help maintain traffic flow along the street and provide a safe work area for the contractors.
Works in Zone 1 (June and July) will impact around 18 to 25 car and motorcycle parking spaces at different times.
Works in Zone 2 (July and August) will impact around 14 to 22 car and motorcycle parking spaces at different times.
Drivers are encouraged to seek alternative parking. Council provides free on-street and off-street parking throughout Maleny.
To see nearby parking options, check out the parking map for Maleny on Council’s website.
Community updates and construction notifications
Community updates and construction notifications
We are committed to updating our community about the Maple Street Streetscape works.
Read the latest Community Updates and construction notifications.
Construction staging (subject to weather and site conditions)
Construction staging (subject to weather and site conditions)
July 2026, Zone 1 - Area 1
- Upgrading raised pedestrian crossing near the IGA (Area 1)
July-August 2026, Zone 2 - Areas 1 and 2
- Constructing new pedestrian crossing near Fig Street (Area 1)
- Constructing new pedestrian crossing near Myrtle Street (Area 2)
- Stormwater works
August-November 2026 | Zone 1 - Areas 1 and 2
- Constructing new pedestrian crossing near the chemist (Area 2)
- Footpath construction
- Verges, kerbing, pavements, furniture and landscaping
December 2026 - February 2027 | Zone 2
- Footpath construction
- Verges, kerbing, pavements, furniture and landscaping
February 2027 | Zones 1 and 2 - Finishing works
- Asphalt finish
- Line-marking and signage
Community engagement and the final design
Community engagement and the final design
The project has a long history of community engagement from 2001 as our community has helped to shape the final design.
To learn about the previous community engagement process, please visit Council’s Have your Say website.
See the project timeline below:
2001-2010, Initial Community Engagement undertaken for Maleny Streetscape Concept Plan (2005)
Early 2022, Project Planning complete
July - August 2022, Phase 1 - Community Engagement ‘Review & Refresh’
To gain feedback on the Maleny Streetscape Diagram.
July – August 2023, Phase 2 - Community Engagement ‘Testing the plan’
To gain feedback on the refined Concept Plan.
December 2022 – April 2023, Detailed design
May - July 2024, Tender documentation
October 2025, Approval received from Department of Transport and Main Roads (DTMR)
December 2025 - May 2026, Contractor procurement
June - December 2026, Construction
What is the level of community support for the project?
Over 66 per cent of participants overall support the streetscape improvements with 67 per cent agreeing the values and vision for Maple Street are reflected in the design.
To learn about the previous community engagement process, please visit Council’s Have your Say website.
Why has the project’s start been delayed previously?
The project has needed to consider a range of factors including available funding opportunities, design considerations, contractor procurement, approvals and coordinating nearby road upgrade works with the QLD Department of Transport and Main Roads (TMR).
With a construction contractor now secured, works can progress.
Why wasn't a bypass built instead?
This project focuses on improving the safety, accessibility and functionality of Maple Street itself through new pedestrian crossings, wider footpaths, improved lighting and landscaping. A bypass was not considered because bypasses are known to have potential unintended consequences, including reduced traffic volumes through town centres, which can adversely affect businesses that depend on passing trade.
What is the design of the raised pedestrian crossings and why are they required?
Raised pedestrian crossings are an important safety feature and reduce vehicle speeds at crossings which in turn increases available time for drivers’ perception and reaction.
Raised crossings improve the visibility of pedestrians, including people with a disability, to drivers.
In the case of the four raised pedestrian crossings at Maple Street the crossings have long approaches and departures for motorists and are only 75mm high rather than a higher ‘speed bump’ type design.
What will the streetscape’s colour palette and materials look like?
The project will use a palette of natural colours and materials in line with Maleny’s character including:
- natural clay feature brick walls
- Corten (weathered steel look) furniture frames with aluminium ‘woodgrain’ battens
- basalt boulders
- custom designed Corten street tree grates
- coloured concrete exposed aggregate footpath.
Extensive landscaping will also help to green and shade the street.
What landscaping is being done?
Landscaping forms an integral part of the Maple Street streetscape upgrade. Over 1500 plants, shade trees, and ground covers will be planted to provide an enhanced and cooler environment for our community to enjoy all year round.
Species selection is based on Sunshine Coast Council’s Street Tree Masterplan recommendations, planting that is endemic to the Regional Ecosystem and some existing (non-native) planting.
Providing more shade and shelter was a key theme shared by our community through community engagement, whilst retaining as many on-street parking bays as possible.
Are any trees being removed?
No trees are being removed. If a tree needs to be trimmed to address safety or other issues during construction, this will be done under the supervision of Council’s arborist team.
What does the heritage trail consist of?
In 2024 Maleny Commerce was awarded a Sunshine Coast Council Community Grant to fund local historian, Timeline Heritage, to collect, organise and make accessible cultural information.
This information will be used in the Maple Street section of the proposed Heritage Trail.
Council will deliver 10-15 Cultural Heritage interpretation elements as part of the streetscape project with the remainder of the trail being delivered by others in the future.
Which areas of the footpath are being upgraded?
As part of the streetscape project some sections of footpath will be replaced. These sections have been identified as the highest priority in terms of improving accessibility. Future consideration will be given to other sections as part of Council’s ongoing asset renewal program.
How will the new works protect, enhance and celebrate the unique character of Maleny?
The streetscape design is guided by the existing character of Maple Street. Street furniture is subtle and blends in with the existing materials present on the street. Planting selection is based on the existing palette and introduces more plants that are native to the area. The Heritage Trial will celebrate Maleny’s strong identity, history and culture.
Why has there been a gap between the community consultation on design, and the start of construction?
The project has needed to consider a range of factors including available funding opportunities, design considerations, contractor procurement, approvals and coordinating nearby road upgrade works with the QLD Department of Transport and Main Roads (TMR). With a construction contractor now secured works can progress.
Can the community of Maleny still have input to the design?
Community engagement has been completed. The community was engaged extensively during the planning and concept design phases of the project in 2005, 2022 and 2023.
What information and updates are being provided to ensure the community is aware of the project and its impacts?
We’re committed to keeping our community informed about the streetscape project and encourage people to support local businesses throughout construction.
This includes:
- Printed Project News mailed to homes and businesses in Maleny before works started.
- A Community Update emailed to all Maleny residents and property owners before works started, outlining the streetscape design and construction timing.
- We encourage our community to register for emailed project updates and construction notifications – straight to your inbox. We will send regular updates and news about the project. Subscribe here.
- Targeted social media campaigns including informing of works coming up, construction timing, ‘support local businesses’.
- Local media coverage.
- Updated project webpage, constantly refreshed with updates, FAQs and construction notifications.
- Printed postcard available in shops and cafes with a QR code directing to the project webpage, where people can subscribe for updates.
- Corflute signs along Maple Street showcasing the before and after images of the refreshed streetscape.
How will the environment be protected during the construction?
The contractor has developed a comprehensive environmental management plan which will guide the works. The plan covers erosion and sediment control, water and air quality, flora and fauna, noise, and waste management.
Funding
Funding
What is the value of the project and how is the project being funded?
The project has a total budget of $3.4 million and is jointly funded by Sunshine Coast Council and the Queensland Government. It has also received funding from a Sunshine Coast Council Heritage Levy Grant.
Why has the construction timeline and staging changed from the original (June 2026) program?
Why has the construction timeline and staging changed from the original (June 2026) program?
We’ve made some changes to the construction program to keep two-way traffic operating along Maple Street and to minimise impacts to businesses and our community over the peak Christmas trading season.
Works will now be staged through to February 2027 with a construction break from 23 December 2026 to 5 January 2027 (inclusive).
Project scope
Project scope
The project is a direct outcome of the Maple Street Streetscape Concept Plan and reflects what the community told us mattered most for Maleny’s main street.
The upgraded streetscape incorporates the area of Maple Street between Myrtle and Teak Streets.
The new streetscape will create a more welcoming and accessible main street through:
- new raised pedestrian crossings with improved lighting
- extended kerbs and footpath upgrades in key areas
- more shade trees and garden areas
- new seating and places for people to meet and gather
- wayfinding signage
- a heritage trail and cultural interpretation elements
- safer and compliant car parking.
Landscaping is a major focus of the upgrade, with more shade trees and gardens to support comfort, sustainability and a greener streetscape. This includes more than 580 new trees and shrubs, along with new seating and community gathering spaces.
The project received additional funding through the Australian Government - Local Roads and Community Infrastructure grant program.
This enabled us to increase the project scope to include upgrades to some key sections of footpaths along the street.
What Community Engagement was conducted as part of the project?
What Community Engagement was conducted as part of the project?
Our community played a strong role in shaping the final design, with extensive community engagement between 2022 and 2023.
More than 66 per cent of participants support the streetscape improvements, with 67 percent agreeing the design reflects the shared values and vision for Maple Street.
The final design uniquely reflects the character and history of the township.
To learn about the previous community engagement process, please visit Council’s Have Your Say website.
Project timeline
Project timeline
2001-2010 - Initial Community Engagement undertaken for Maleny Streetscape Concept Plan (2005)
Early 2022 - Project Planning complete
July - August 2022 - Phase 1 - Community Engagement ‘Review & Refresh’
To gain feedback on the Maleny Streetscape Diagram.
July – August 2023 - Phase 2 - Community Engagement ‘Testing the plan’
To gain feedback on the refined Concept Plan.
December 2022 – April 2023 - Detailed design
May - July 2024 - Tender documentation
October 2025 - Conditional approval received from Department of Transport and Main Roads (DTMR)
December 2025 - May 2026 - Contractor procurement
June 2026 - Contractor site office establishment
Community updates - Approval to proceed application to Department of Transport and Main Roads (DTMR)
July 2026 to February 2027 (weather permitting) - Construction
We’ve engaged local company Disc Landscapes to deliver the works.
- Start: Week commencing Monday 6 July 2026
- Finish: Late February 2027 (weather and site conditions permitting)
Works will be done in stages across two zones to reduce impacts:
- Zone 1: Teak Street to Fig Street
- Zone 2: Fig Street to Myrtle Street
We’ll share clear timing for each stage as we go.
Help us maintain a safe and respectful work environment
Help us maintain a safe and respectful work environment
Our crews are working hard to deliver improvements for the community and appreciate your patience and understanding during construction.
We kindly remind everyone to be respectful and considerate towards Council staff and contractors working on site. Our crews are working hard to deliver improvements for the community and appreciate your patience and understanding during construction.
We thank our community for your many kind comments about the friendly construction workers.
Please note that the site construction office is for Disc staff only and is not able to accommodate community enquiries. For any questions or feedback about the streetscape project, please:
📧 Email the project team: [email protected]
📞 Contact Sunshine Coast Council Customer Service
Thank you for helping us maintain a safe and respectful work environment for everyone.
Further information and how to stay updated
Further information and how to stay updated
How can I find out more about the project or contact the project team?
To contact Council’s project team please email [email protected]
Or contact Council’s customer service via the details below, quoting ‘Maple Street Maleny Streetscape Project’
- Email: [email protected]
- Phone: 07 5475 7272
- Mail: Locked Bag 72 Sunshine Coast Mail Centre Qld 4560
How do I register for construction updates?
You can register to receive our regular construction notifications straight to your inbox by subscribing here.
You can unsubscribe at any time.
Please share this information with people who may have an interest in the project and would like to receive emailed updates.
Stay updated
Make sure you stay up to date by subscribing to receive project updates and information on construction works - straight to your inbox. You can unsubscribe at any time.
Sneak peek: Maple Street's new look
Scroll right to see the before and after images (artist impressions) of the streetscape upgrade.
If you have a question for the project team, please email [email protected]
